Pick a passive system governed by IEC 62305 for critical or high-consequence sites, including data centers, chemical storage, and anywhere continuity of operations matters. Consider an active, or ESE, system under NF C 17-102 when roof geometry, heritage constraints, or coverage economics make a conventional mesh impractical. That is the entire decision in one line, but the fine print matters because ESE devices carry evidence and maintenance implications that change your certification path.

  • Critical or high-risk sites: IEC 62305, layered passive protection, full documentation trail
  • Constrained or large-footprint sites: NF C 17-102 may support an ESE terminal such as Indelec’s Prevectron3
  • Either path: independent test certificates and a maintenance contract are non-negotiable

Key Takeaways

The difference between passive and active systems comes down to interception method and evidence base: passive protection is continuous and standards-proven under IEC 62305, while active/ESE protection is event-triggered and standards-accepted under NF C 17-102 with a thinner independent evidence base.

PointDetails
Standard follows riskCritical or high-consequence sites belong under IEC 62305’s layered, risk-assessed approach.
ESE has real limitsNIST found published ESE literature insufficient for a complete independent performance assessment.
Five components, alwaysAir termination, conductors, grounding, bonding, and SPDs must all be present and documented.
Maintain to the original standardRetrofits should follow the standard the system was originally designed and certified under.
Indelec fits both pathsIndelec designs to IEC 62305 or NF C 17-102 and offers Prevectron3 where ESE is the compliant, economical fit.

Standards and Reviews Worth Keeping on File

  • Mandatory standards: IEC 62305 (risk-based LPS design), NF C 17-102 (ESE-inclusive framework)
  • Independent technical review: NIST IR 5621 on ESE devices
  • Advisory/technical papers: industry comparisons of active vs. passive lightning conductor performance and standard selection guidance

Table of Contents

Difference Between Passive and Active Systems: The Mechanics

A passive lightning protection system works on interception, conduction, and dissipation. Air terminals (Franklin rods or a mesh network) catch the strike, low-impedance downconductors carry the current, and an earth termination network dissipates it into the ground. Internal equipotential bonding and surge protection devices (SPDs) stop the current from jumping across metal systems inside the building. Nothing about this depends on power, sensors, or a trigger event. It just sits there, ready.

Active systems, more precisely early streamer emission (ESE) devices, aim to trigger an upward leader earlier than a plain rod would, extending the terminal’s claimed capture radius. Manufacturers use radioactive, electrical, or piezoelectric triggering mechanisms, though radioactive designs carry environmental and health baggage that electrically triggered units avoid. The trigger fires in the fraction of a second before a natural strike would attach, which is also why so much of the debate around active vs. passive systems centers on how that timing is measured and verified.

  • Passive protection zones are typically calculated with the rolling sphere method or a protective cone/angle
  • Active terminal coverage is often expressed as a claimed protection radius tied to the device’s rated capture advantage
  • Passive systems need no power supply; active units may need periodic function checks and, on some models, status monitoring

Pro Tip:Ask any ESE vendor for the exact trigger mechanism and its independent test report before comparing claimed radii; two devices with the same rated advance time can behave very differently in the field.

Standards and Design Frameworks: IEC 62305 vs. NF C 17-102

The standards you design to determine what you have to document, test, and defend to an insurer. IEC 62305 takes a risk-based, layered approach: it defines Lightning Protection Levels (LPL I through IV), each with its own rolling-sphere radius and mesh sizing rule, and it folds external LPS, internal bonding, and SPD coordination into a single risk-assessment file. NF C 17-102, a French national standard, instead builds its verification logic around the ESE terminal itself, which is why it accommodates active/ESE air terminals more directly.

  • IEC 62305: risk-calculated, LPL-classed, mesh and rolling-sphere sizing, strong international insurer acceptance
  • NF C 17-102: equipment-centered logic, designed to work with ESE claims, common on sites already using active terminals

Choosing between the two “isn’t about which framework is better; it’s about which one matches the site’s actual risk profile.” Higher LPL classes under IEC 62305 require denser air termination coverage and tighter conductor specifications, which is one reason the risk file it produces tends to travel well across borders for multinational operators and insurers reviewing a facility they’ve never visited.

What the Evidence Actually Says About ESE Devices

Independent research on active systems is thinner than the marketing suggests. NIST’s own technical review found that ESE terminals do use triggering intended to initiate an earlier upward streamer, but the published literature was insufficient to make a complete independent performance assessment for many ESE technologies. That is not a dismissal of the category. It is a statement that the data available at the time didn’t settle the question either way.

Other technical work adds nuance rather than closure. Lab and field tests in some studies show ESE terminals producing a larger capture range under specific conditions, but the stochastic nature of leader attachment and the simplifications baked into rolling-sphere modeling mean results are context dependent, not universal.

Independent reviews consistently note that much of the available ESE performance data is manufacturer-generated. Before procurement, ask for third-party lab reports and in-situ field verification, not just the device’s rated capture advantage.

  • Open questions: polarity dependence, how long pre-ionization actually lasts, and the rarity of realistic experimental methods (rocket-triggered lightning, laser-guided discharge)
  • What to request: third-party lab certificates, published test-bench data, and field verification records, not manufacturer white papers alone
  • Modeling caveat: rolling-sphere and mesh calculations simplify a genuinely stochastic phenomenon on both passive and active designs

A Site-by-Site Decision Checklist

Run every project through a risk and consequence filter before you touch a product catalog. A data center, a fuel storage facility, or a hospital with life-safety systems belongs under IEC 62305’s layered passive approach, full stop, because the cost of a failure dwarfs the cost of the system. A large, low-access roof, a historic building where you can’t run a dense mesh, or a site already carrying an ESE installation is where an active/ESE evaluation under NF C 17-102 earns its place.

  • Map site risk and consequence class before selecting a standard
  • Check roof geometry, heritage restrictions, and access constraints against both approaches
  • Confirm insurer and local code acceptance in writing before finalizing design
  • Require documented compliance, third-party test certificates, a maintenance plan, and warranty terms in every bid
CriteriaPassive (IEC 62305)Active/ESE (NF C 17-102)
Principle of operationDirect interception via mesh/rods, no trigger eventTriggered early streamer, event-based capture claim
Protection zone calculationRolling sphere, protective angle, LPL-based mesh sizingClaimed protection radius from rated advance time
Standards complianceRisk-assessment file, LPL I to IV classificationEquipment-centered verification per NF C 17-102
Site suitabilityCritical, high-consequence, or internationally exposed sitesLarge or constrained roofs, heritage limits, existing ESE base
Installation and groundingDenser conductor network, more grounding points at higher LPLFewer terminals, but each carries device-specific mounting rules
Maintenance and monitoringVisual and resistance testing on a fixed intervalFunction checks plus device-specific inspection, some units support remote status
Cost profileScales with mesh density and earthworksScales with device count and certification, not conductor volume

Pro Tip:Bring the LPS design engineer, the certifying body, and the insurance technical reviewer into the same conversation before you commit to a standard. Retrofitting a compliance gap later costs far more than an extra design meeting now.

Building It Right: Air Terminals, Grounding, and Bonding

Every compliant system, passive or active, rests on the same five components: strike termination, conductors, grounding electrodes, bonding, and surge protection. Skip one and the rest of the system underperforms regardless of which terminal sits on the roof.

Grounding arrangement depends on the build. Type A uses individual earth electrodes at each downconductor base and suits many retrofits where a ring isn’t feasible. Type B uses a ring or foundation electrode around the perimeter and is generally the stronger choice for new construction. Internal protection needs equipotential bonding, adequate separation distance between the LPS and internal metalwork, and SPDs coordinated across Type 1, 2, and 3 categories at the service entrance, distribution boards, and sensitive equipment.

ComponentPassive requirementActive/ESE consideration
Air terminationMesh or rod spacing tied to LPL classSingle or multiple ESE terminals per coverage claim
DownconductorsSized and spaced per LPL, corrosion-protected fixingsFewer runs, still need mechanical support and bend-radius control
Earth terminationType A or Type B, resistance-testedSame grounding rules apply regardless of terminal type
SPD coordinationType 1/2/3 staged by distance from service entranceIdentical requirement, independent of air terminal choice

Installation quality controls, conductor supports at correct intervals, proper bending radii, corrosion protection, and as-built documentation matter just as much as the design on paper. A perfectly specified system installed with sloppy fixings is not a compliant system.

Cost Drivers and Realistic Project Timelines

Roof access and scaffolding usually drive early cost more than the conductor itself, especially on tall or complex industrial roofs. Earthworks for a Type B ring electrode add cost on new builds; retrofits often lean on Type A instead to avoid trenching. Conductor material, downconductor count, SPD staging, and testing/certification round out a passive budget. Active/ESE systems shift some of that cost into device certification, monitoring hardware, and shorter maintenance windows since triggered terminals typically need more frequent function checks than a static rod.

  • Survey and risk analysis: the foundation step, and the one most often rushed
  • Detailed design: standard selection locks in most downstream costs here
  • Procurement lead time: SPDs and specialty conductors can be the long pole
  • Installation, commissioning, and certification: the final gate before handover

Medium industrial projects typically run from a few weeks for survey and design to several months for full installation and certification, with variance driven mostly by scaffolding access and earthworks rather than the terminal choice itself.

Certification, Inspection, and What Auditors Check

Expect to hand over a design file, a risk assessment if you’re under IEC 62305, installation records, component test certificates, and a maintenance log. Inspectors check visual condition, conductor continuity and resistance, earth resistance values, and SPD function. Active systems add a check on the trigger mechanism and, where fitted, monitoring/status logs.

  • Visual inspection of all accessible conductors and terminals
  • Continuity and earth resistance testing on a fixed cycle
  • SPD functional verification, with replacement where indicators show depletion
  • For ESE units, function testing per the device’s certification and maintenance to the original governing standard, since switching standards mid-life without a system-wide upgrade can create acceptance gaps

Insurers and auditors generally favor the risk file that IEC 62305 produces because it documents the reasoning, not just the hardware, behind the design choice.

How a Supplier Should Frame Your Options

A supplier worth hiring starts with a site risk analysis, not a product pitch. That analysis should determine component selection, not the other way around. Indelec’s Prevectron3 fits sites where ESE acceptance is permitted under NF C 17-102 and where coverage economics genuinely favor fewer terminals, such as large open roofs or sites with an existing active installation. It is not positioned as a universal replacement for a layered IEC 62305 design on high-consequence sites.

  • Require a documented site survey before any product is specified
  • Ask for design-to-standard documentation, whichever standard applies
  • Confirm certified installation, a maintenance contract, and monitoring options in the same proposal
  • Get the certificate of conformity and independent test reports in writing before signing

Pro Tip:Put “third-party test report” and “maintenance SLA” as line items in your RFP, not assumptions. A vendor who hesitates on either question is telling you something.

A Practical Rule of Thumb

Match the standard to the consequence of failure, not to whichever terminal looks cheaper on paper. Documentation and lifecycle maintenance cost more over ten years than any marketed capture-radius claim ever saves you.

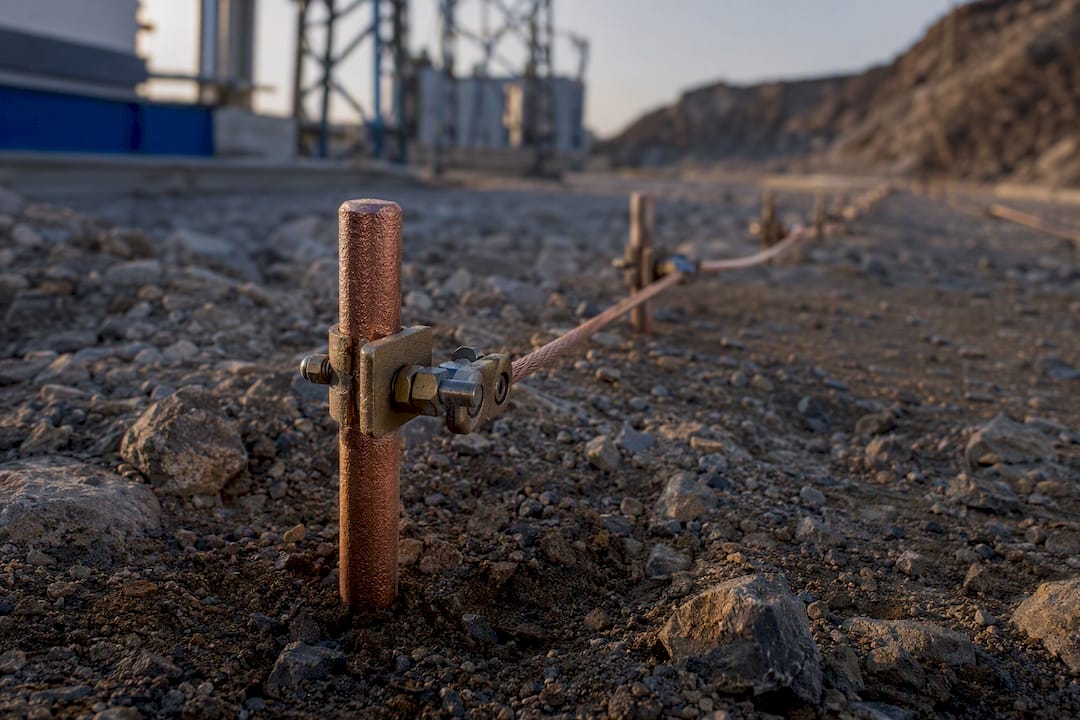

Grounding electrode and clamps in industrial soil
